What a canceled battery project in Tewksbury says about New England’s aging power grid

The corporate behind a big and controversial proposed battery mission in Tewksbury pulled the plug on the event this week after studying it must pay $65 million to connect with the electrical grid. That is greater than thrice what the corporate, East Level Vitality, had anticipated to pay to convey its mission on-line.

Whereas the choice was celebrated by many residents who oppose the mission, state officers and local weather advocates say the cancellation highlights a steep barrier Massachusetts faces in constructing extra clear power: the usually exorbitant value of connecting initiatives to an ageing grid.

In a submitting submitted to the state this week, East Level Vitality stated its plans for the Tewksbury battery power storage system, often called the Hillman Vitality Heart, not penciled out.

“Sadly, rising interconnection prices have made it cost-prohibitive to finish the mission, and East Level Vitality is discontinuing its improvement,” Maggie Howe, the corporate’s vp of mission improvement, wrote in an e mail.

Grid-scale battery power storage programs just like the one proposed in Tewksbury are designed to soak up and retailer extra — and comparatively low-cost — electrical energy from the grid, after which launch it when demand or costs spike.

If constructed, the Tewksbury mission would have housed 134 lithium-ion batteries, every in regards to the measurement of a tractor trailer. The batteries have been going to be positioned on a former industrial website by an current Nationwide Grid substation, and close to a residential group. They’d have a collective capability of 125 megawatts — sufficient power to energy 125,000 houses for 4 hours — making it a chief instance of the kind of battery park the state has made an enormous push to construct in recent times.

“The deployment of storage assets is central to Massachusetts’ affordability, reliability, and clear power technique,” state Vitality and Environmental Affairs Secretary Rebecca Tepper wrote in a letter to the pinnacle of ISO New England, the regional grid operator, earlier this summer season. “Storing electrical energy when it’s ample and delivering it when wanted helps decrease prices for customers, strengthens grid reliability throughout peak electrical energy demand, and allows higher integration of fresh power assets like photo voltaic and wind.”

There are a handful of working grid-scale battery initiatives in Massachusetts, although the state needs many extra within the coming years. Earlier this yr, Gov. Maura Healey set a objective of getting 5,000 megawatts of recent power storage on-line or in improvement by 2035.

The Healey administration declined to touch upon the cancellation of the Tewksbury mission, however in her letter to the pinnacle of ISO New England, Tepper expressed issues about excessive interconnection prices, particularly for batteries. These prices, together with lengthy improvement timelines for grid upgrades, might have “a major chilling impact on funding in Massachusetts and throughout the New England area for years to return,” she wrote.


When East Level Vitality first proposed the Tewksbury mission final March, the developer knew it must pay a number of million {dollars} to connect with the grid — cash that might go to cowl the price of enhancing a close-by substation and upgrading different grid infrastructure. However final month, ISO New England notified the corporate it must pay $65 million.

This further — and sudden — value rendered the mission “economically unviable,” in accordance with the corporate.

“ This is not going to have an effect on simply the Tewksbury mission. It’ll have an effect on initiatives throughout the Commonwealth as a result of ISO New England has put these connection prices in which can be far in extra of what anyone anticipated,” stated Tewksbury City Supervisor John Curran.

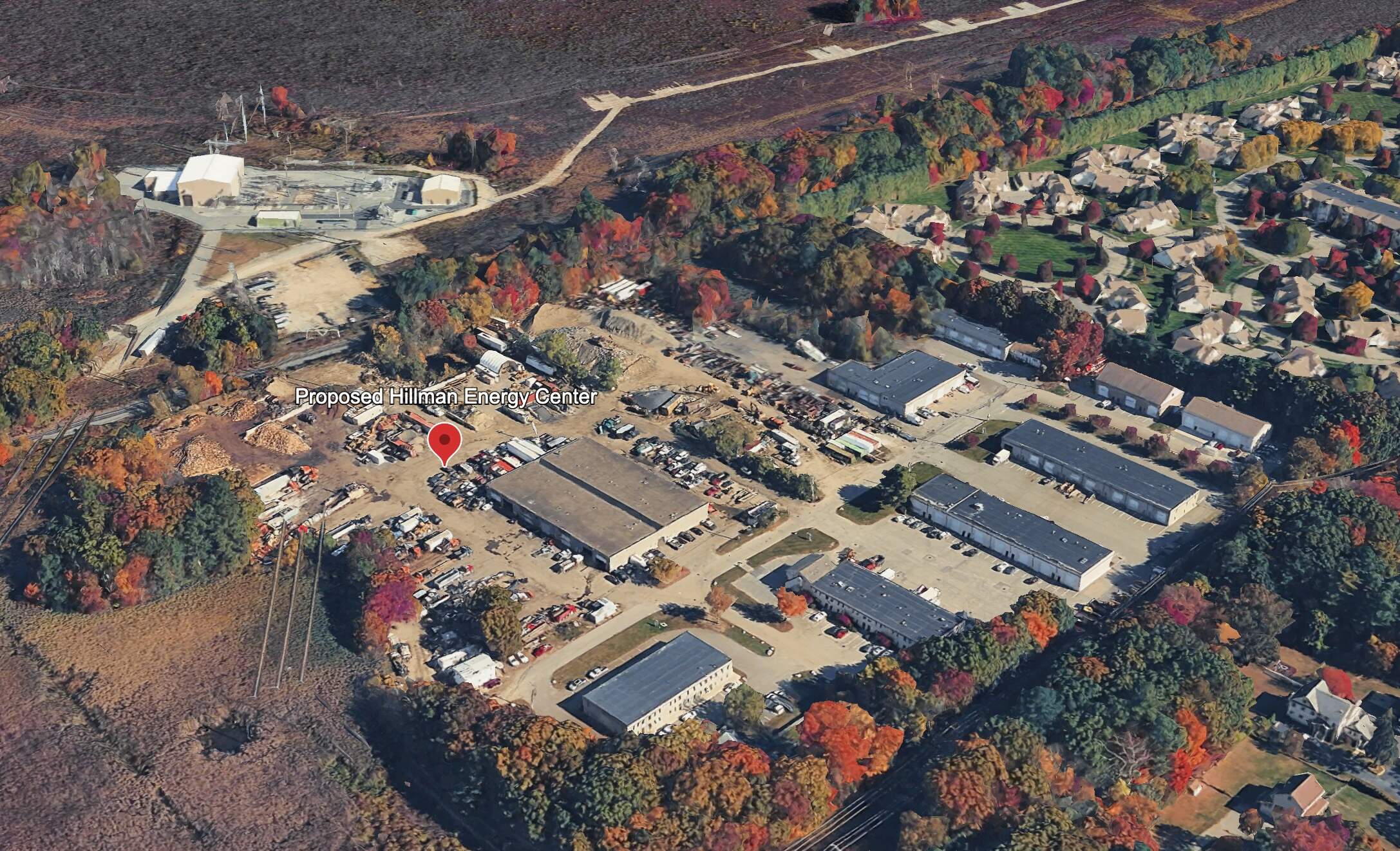

The proposed battery project in Tewksbury would have been built on a former industrial site. (Screenshot/Google Earth)
The proposed battery mission in Tewksbury would have been constructed on a former industrial website. (Screenshot/Google Earth)

New England’s power grid is previous and congested, and desires upgrades to permit extra initiatives like this one to return on-line. Amy Boyd Rabin, vp of coverage on the Environmental League of Massachusetts, stated the area ought to search higher methods for funding these enhancements.

“We have to change how we’re allocating the prices of doing these upgrades and making the grid that we’d like right into a actuality as a result of,  because it stands, we’re crushing initiatives that might convey advantages to ratepayers,” she stated.

Matt Kakely, a spokesperson for ISO New England, declined to remark particularly on the Tewksbury mission, however stated that its interconnection charge was really on the low facet. Of the 23 initiatives the group checked out in its most up-to-date interconnection examine — 18 of which have been battery initiatives — the typical interconnection charge was $178 million, he stated.

“ISO New England’s function is to review initiatives wanting to connect with the system,” Kakley wrote in an e mail. “Throughout our years of performing this function, we’ve seen hundreds of megawatts of assets efficiently come on-line, and hundreds of [megawatts] of assets withdraw earlier than industrial operations for a wide range of causes, together with interconnection prices, financing, native opposition, and different points.”

In Tewksbury, opponents of the the mission cheered its cancellation.

Christine Chesbrough, a Tewksbury resident who lives a few mile from the place the storage facility would have been constructed, stated she was pleasantly shocked when she heard East Level Vitality was spiking the mission. Chesbrough was a part of a gaggle of native residents who mounted a vocal marketing campaign in opposition to the mission on-line and at public conferences, largely over issues about public security.

“We’re very completely satisfied,” she stated. “This has been an enormous, lengthy combat. The vast majority of the residents that I’ve spoken to don’t need this right here.”
